Construction Updates

Tej Elevia

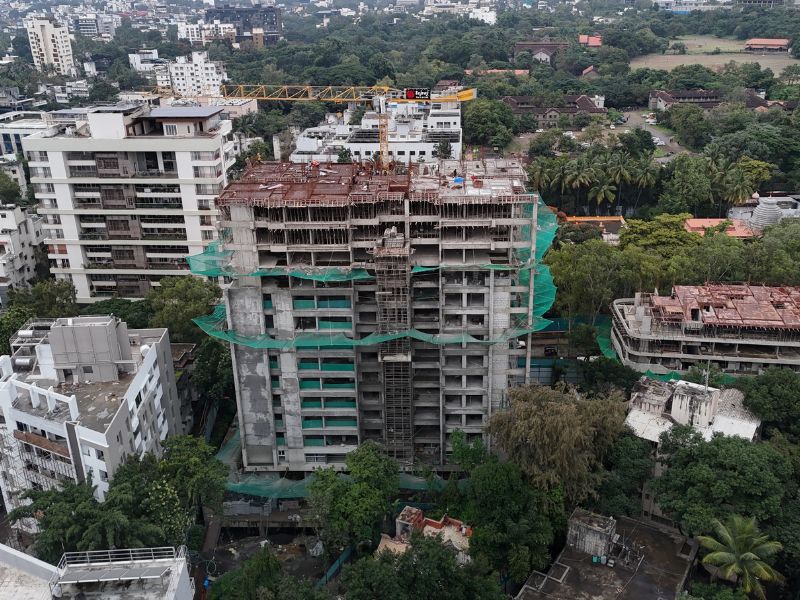

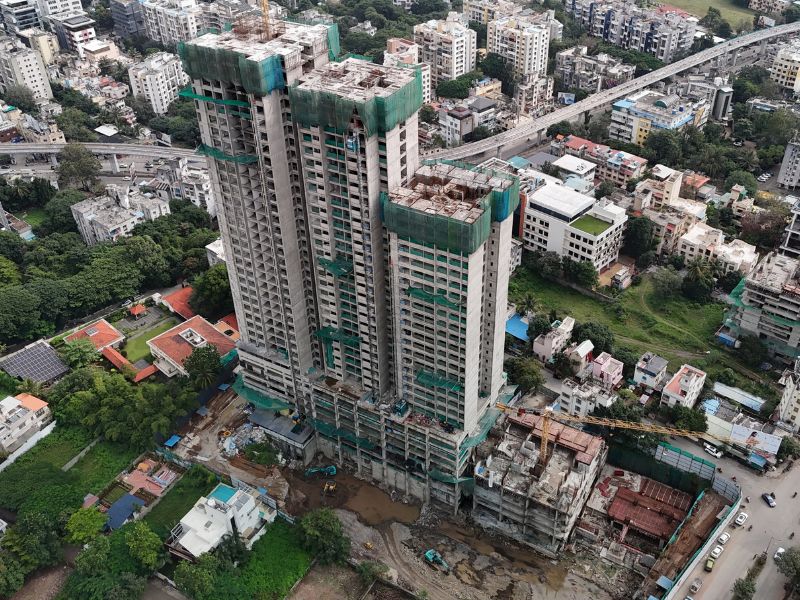

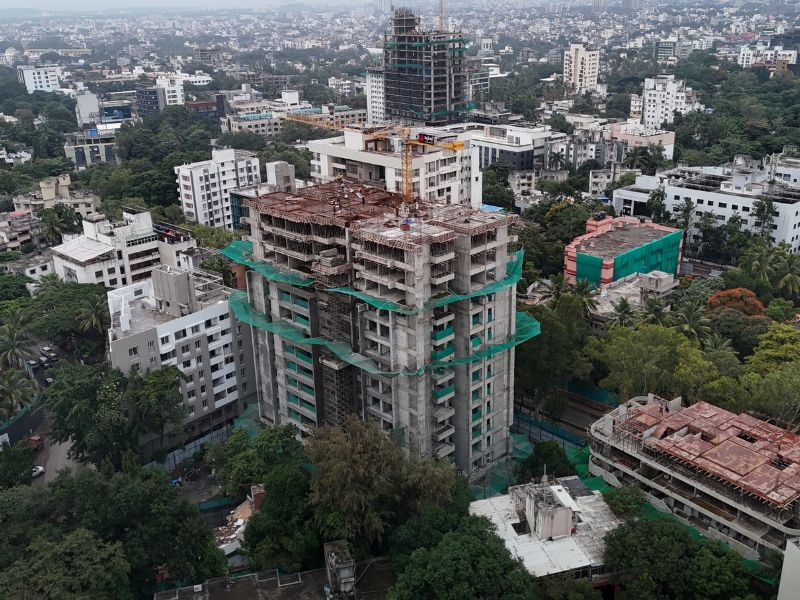

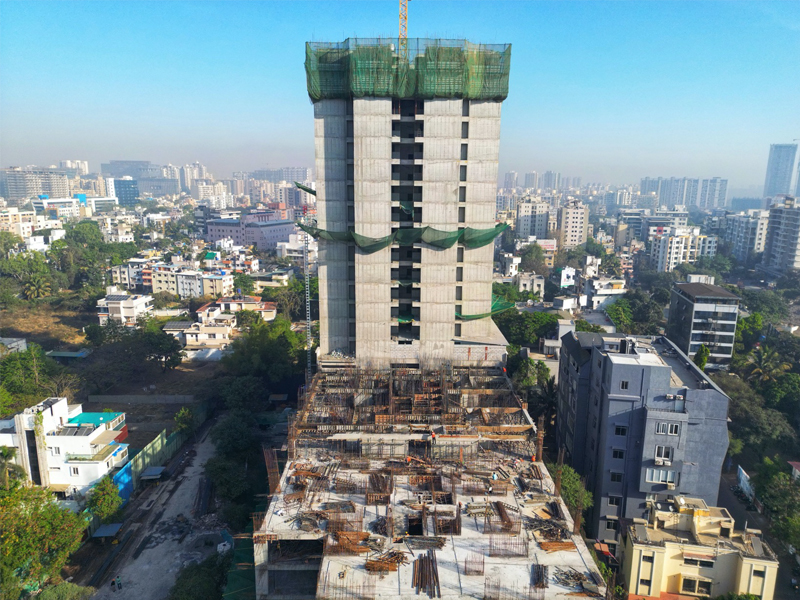

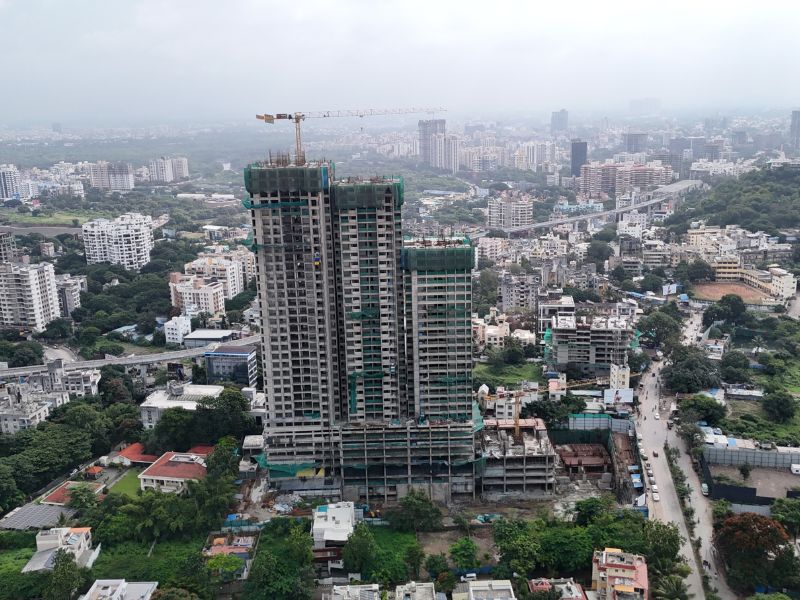

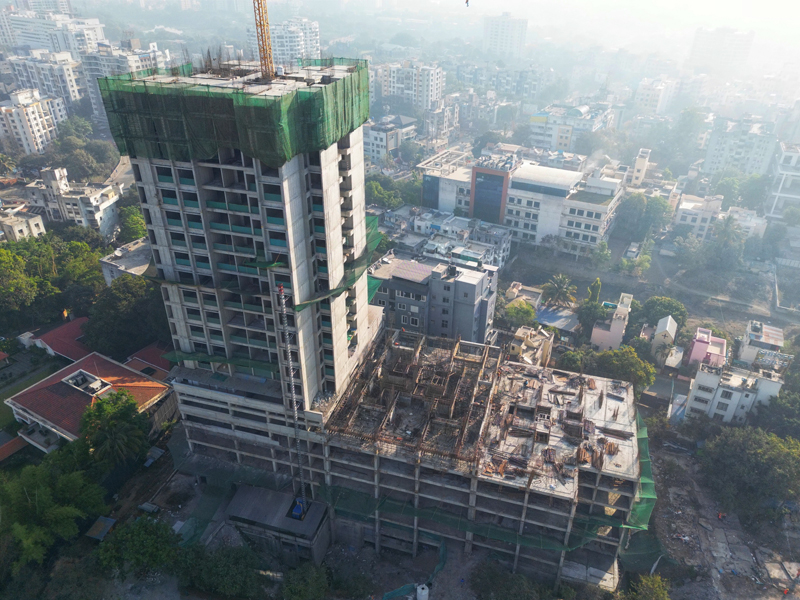

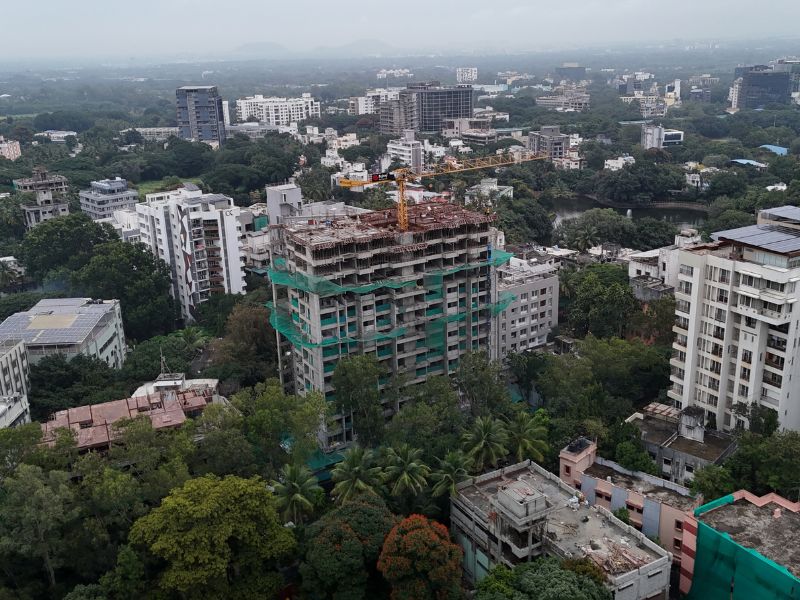

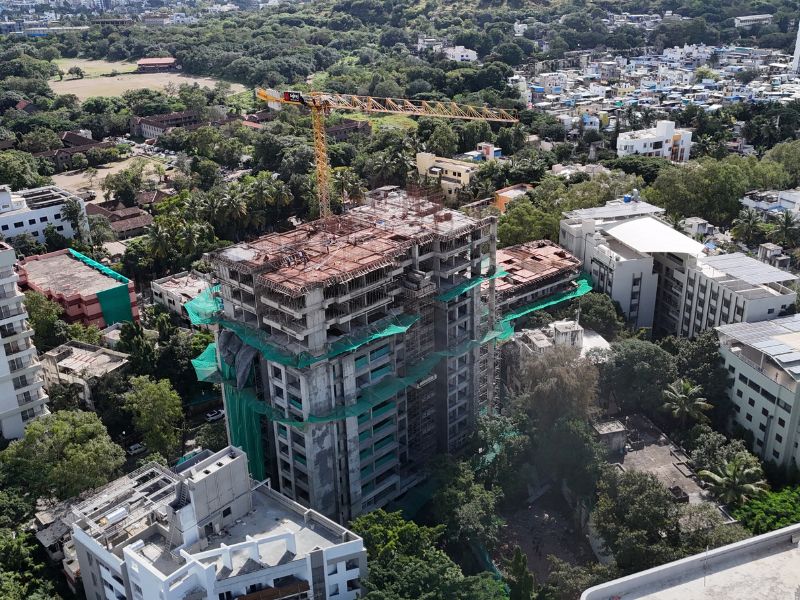

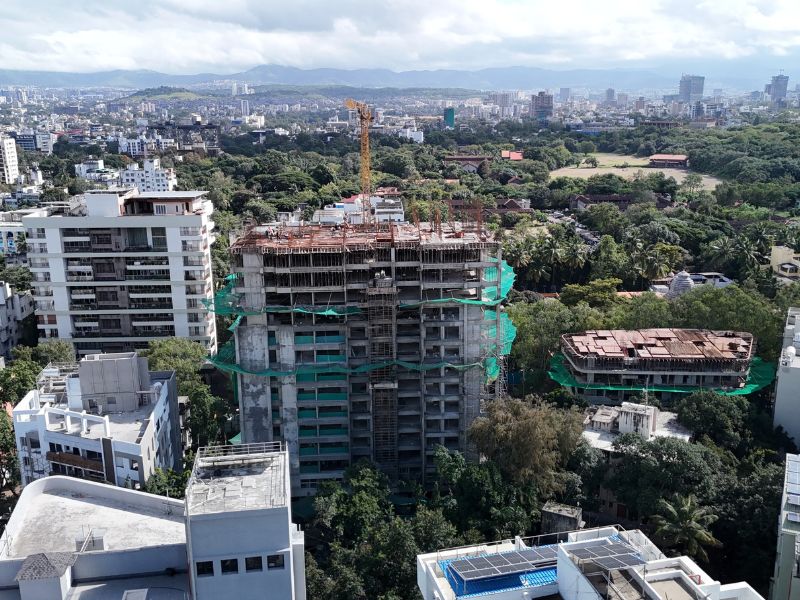

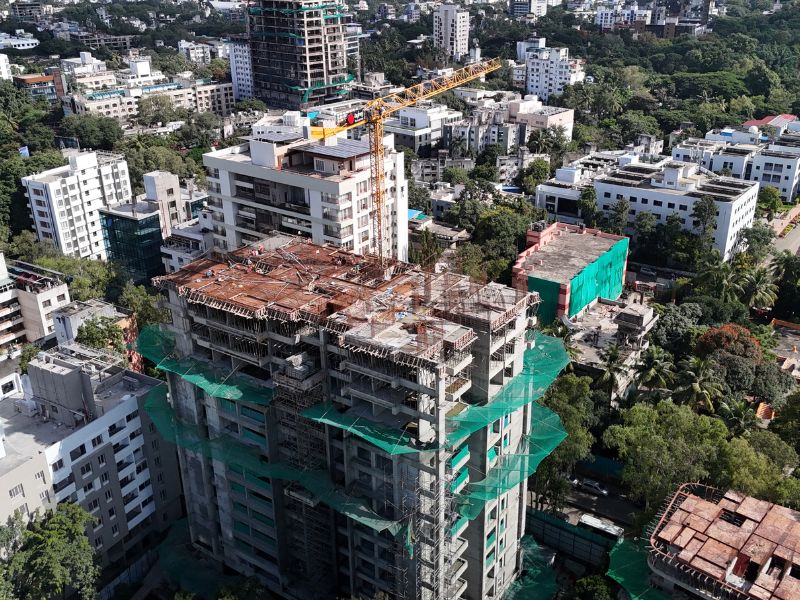

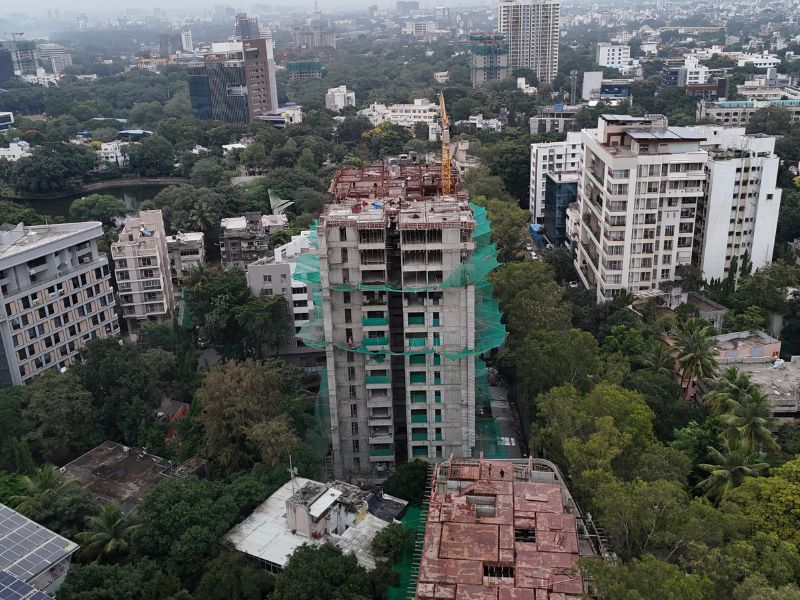

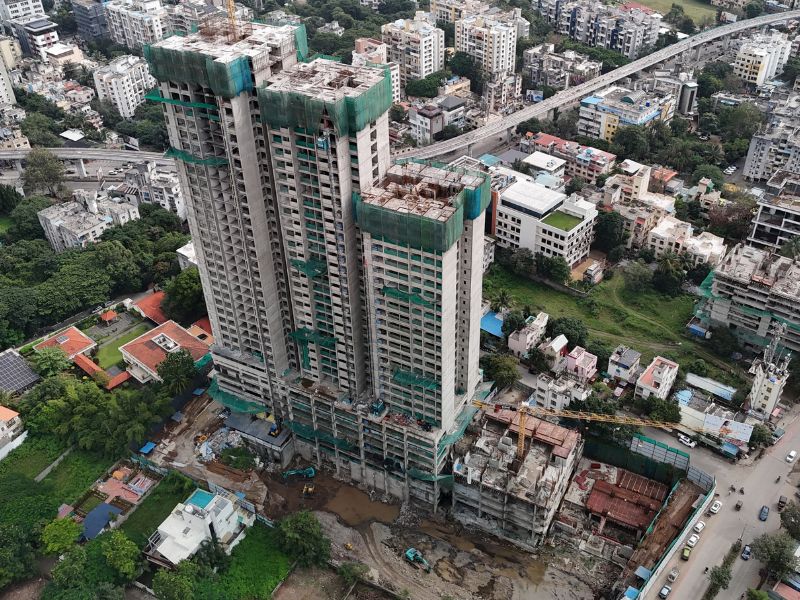

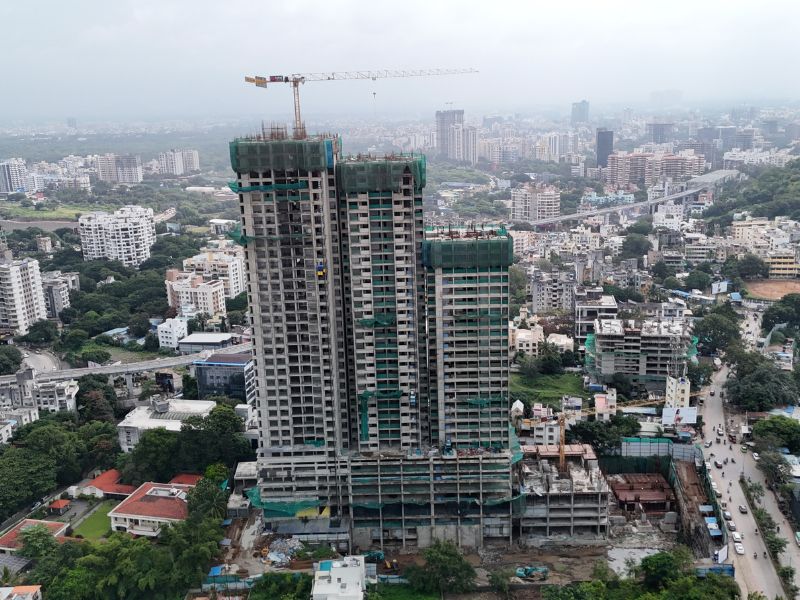

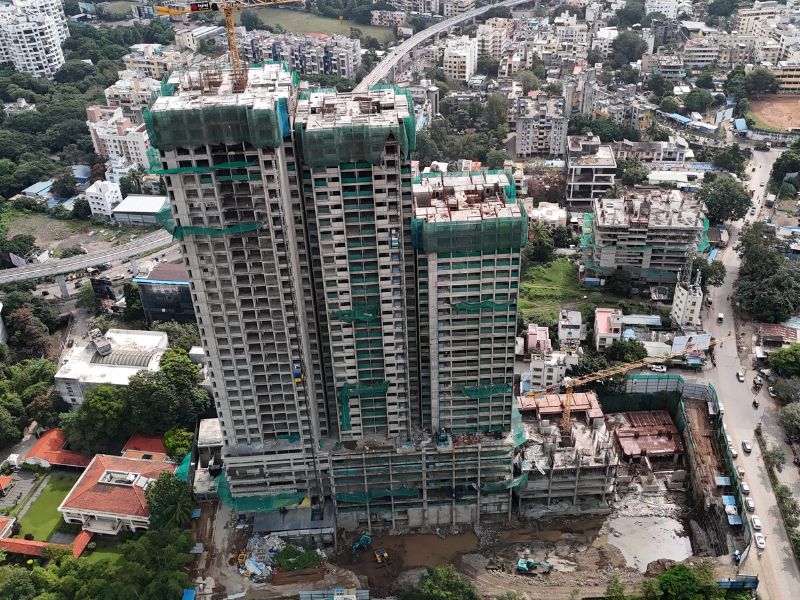

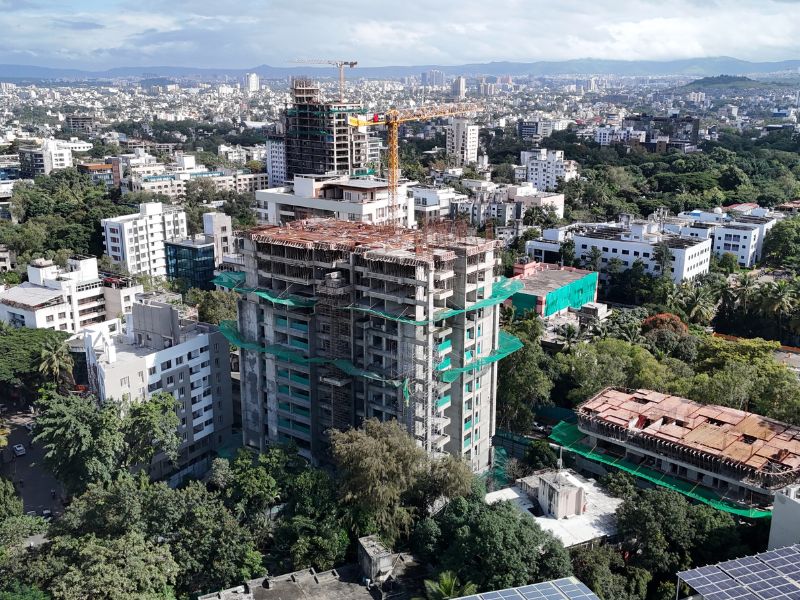

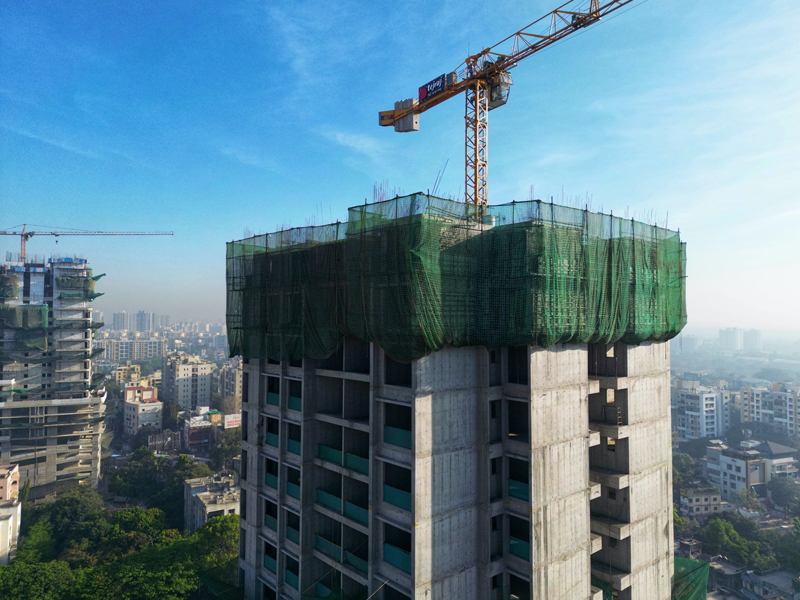

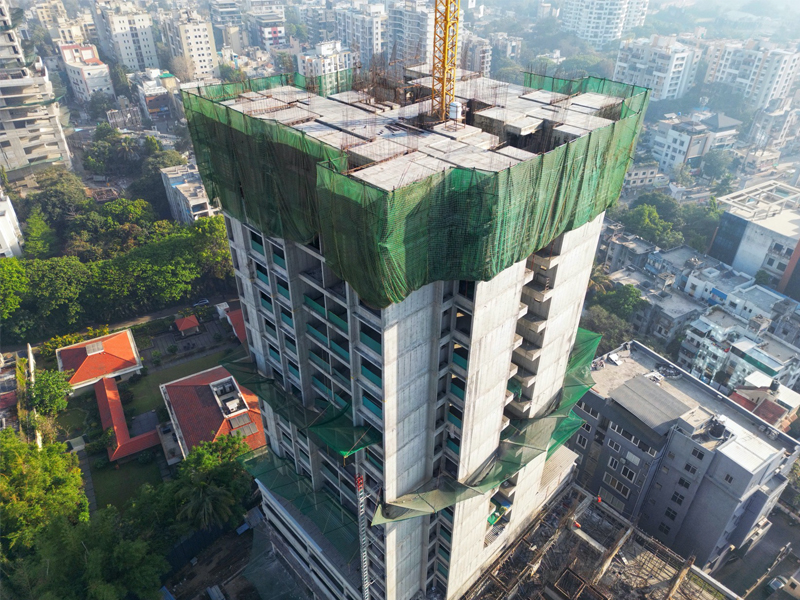

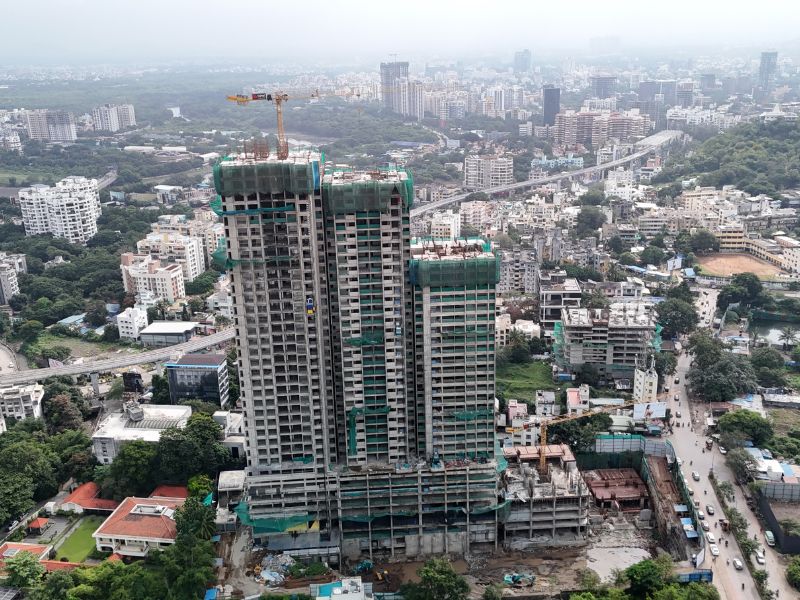

Tower A is continuing its work, focusing on the 16th residential floor. Tower B is progressing with the last roof of the parking floor and the 1st residential 2 floor, while Tower C is advancing with the last roof of the parking floor and the 1st residential floor.

Tej Mayurban

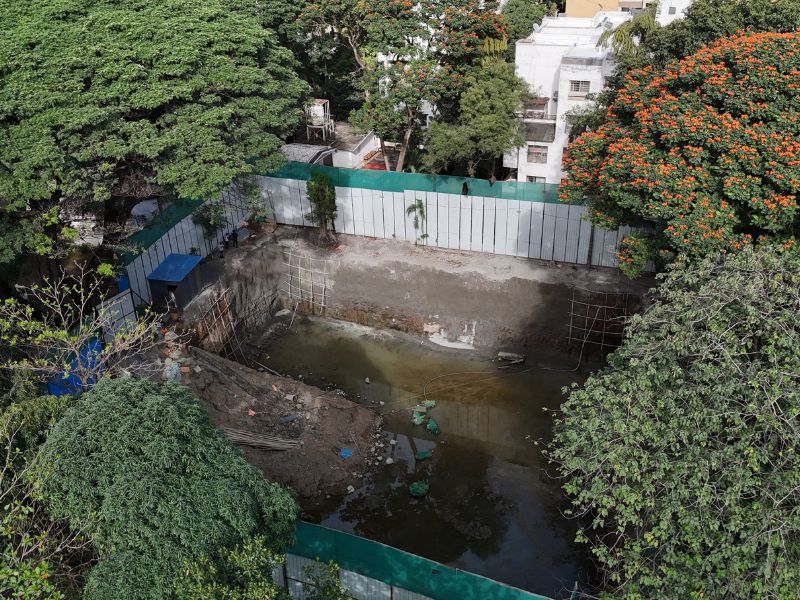

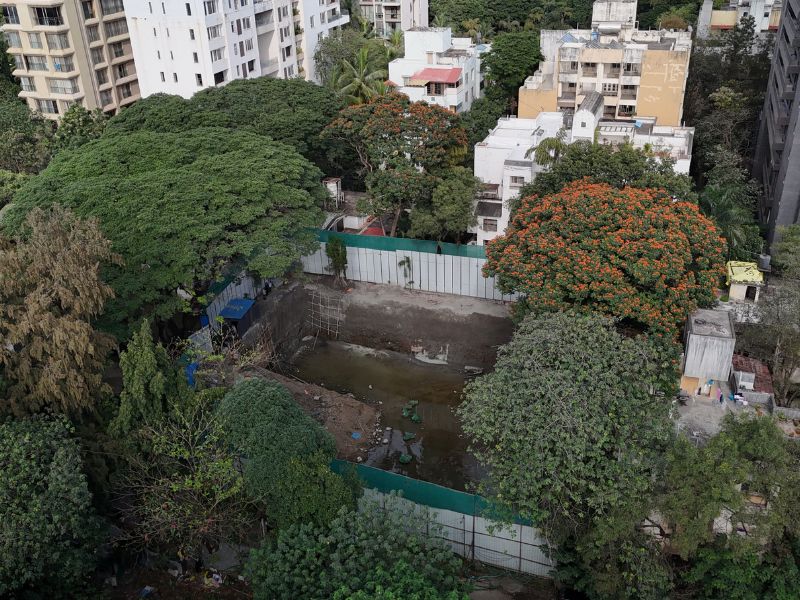

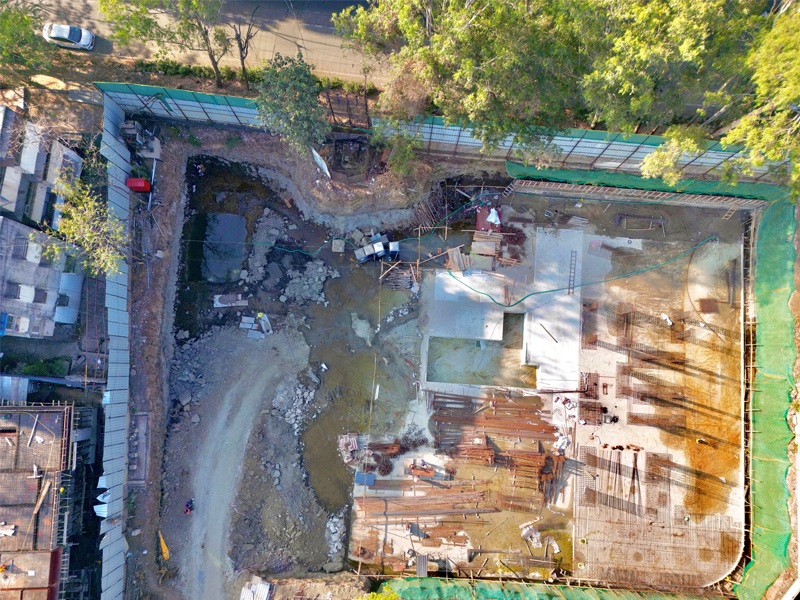

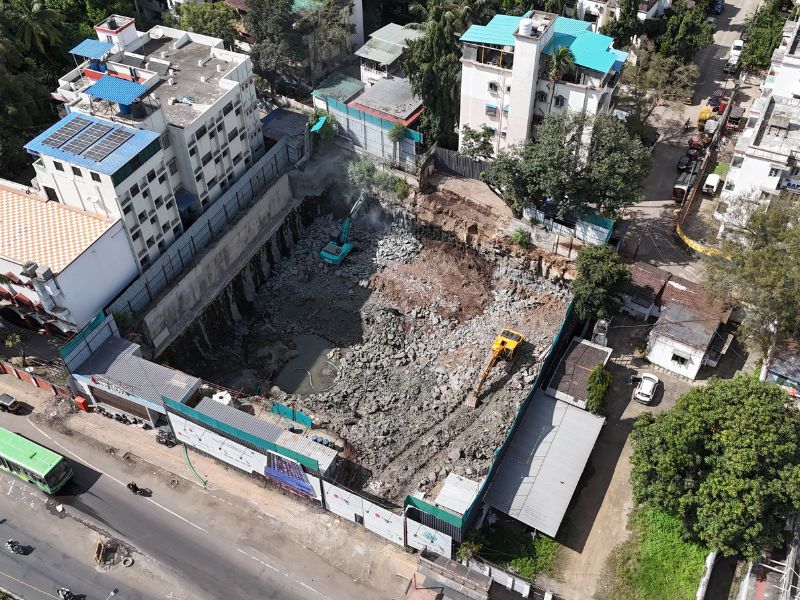

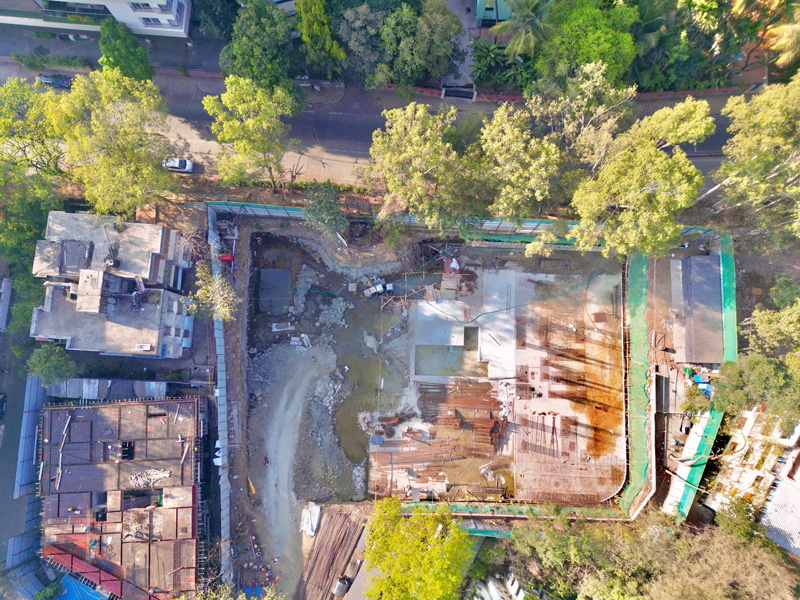

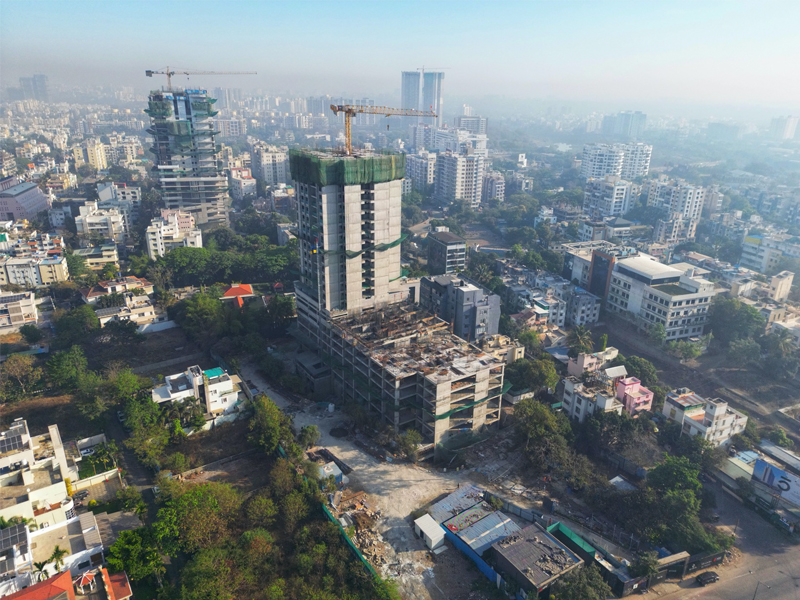

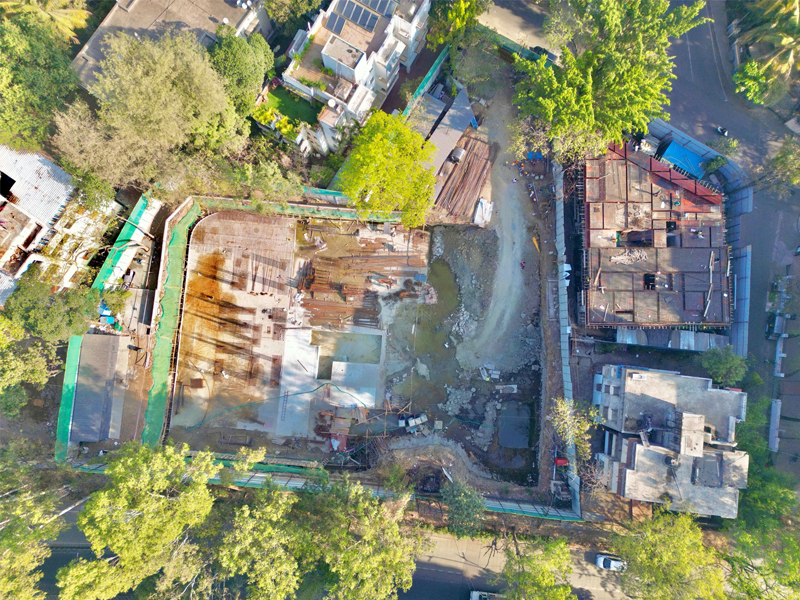

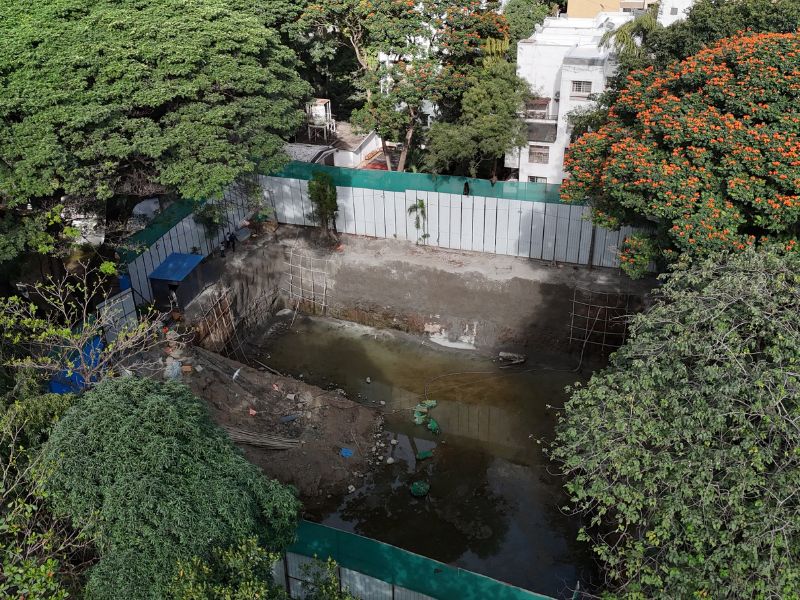

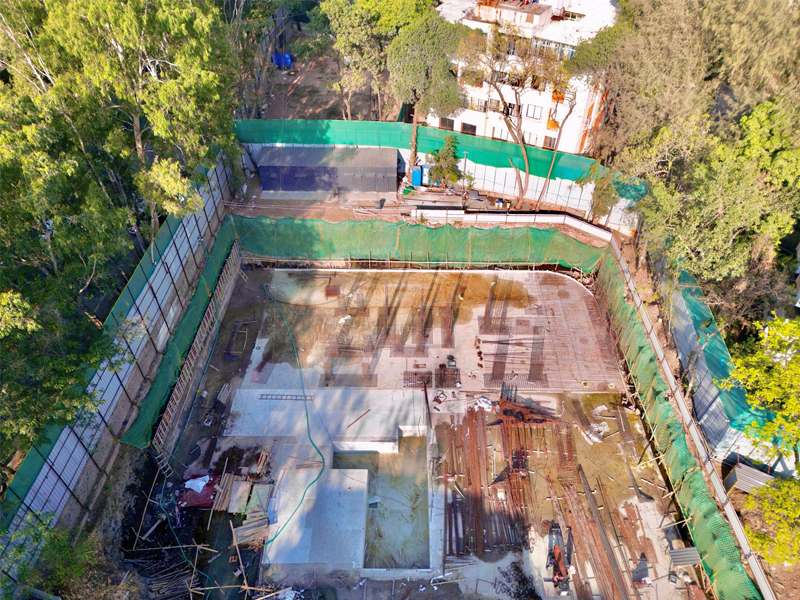

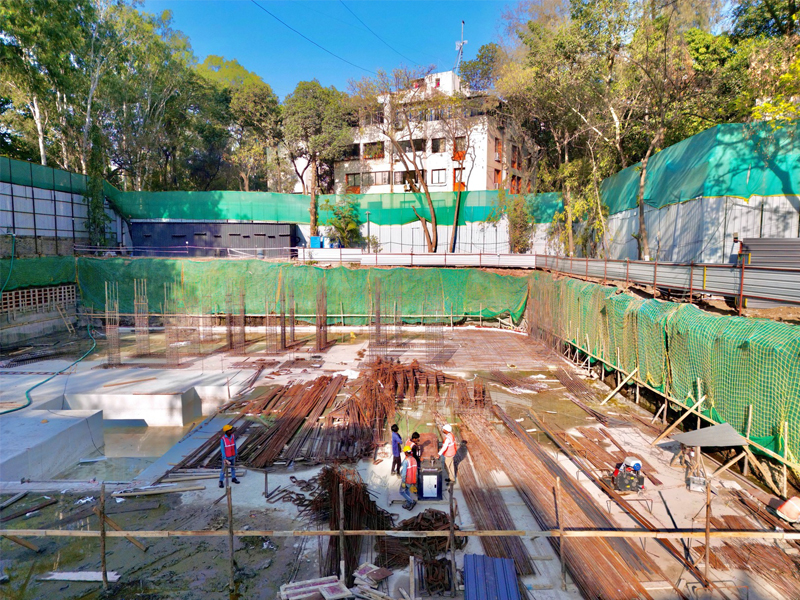

The excavation has been completed, and foundation work is now in progress.

Tej Navya

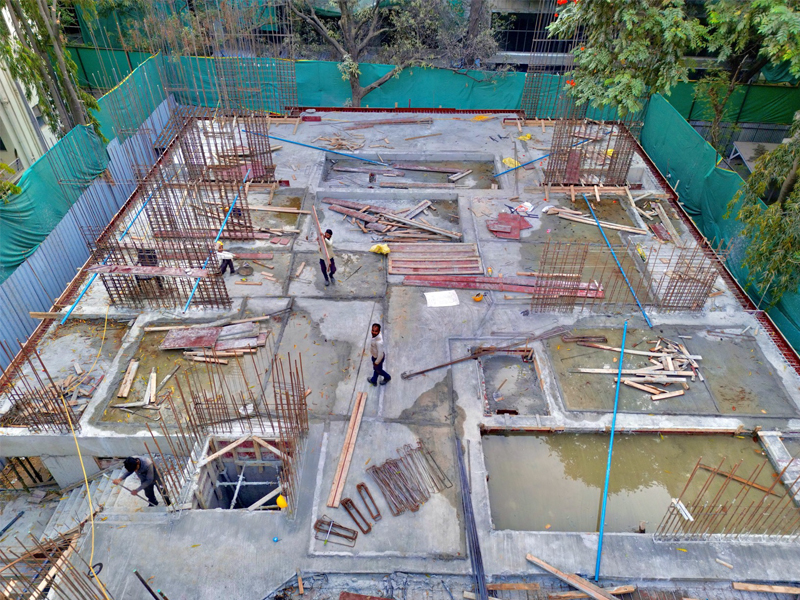

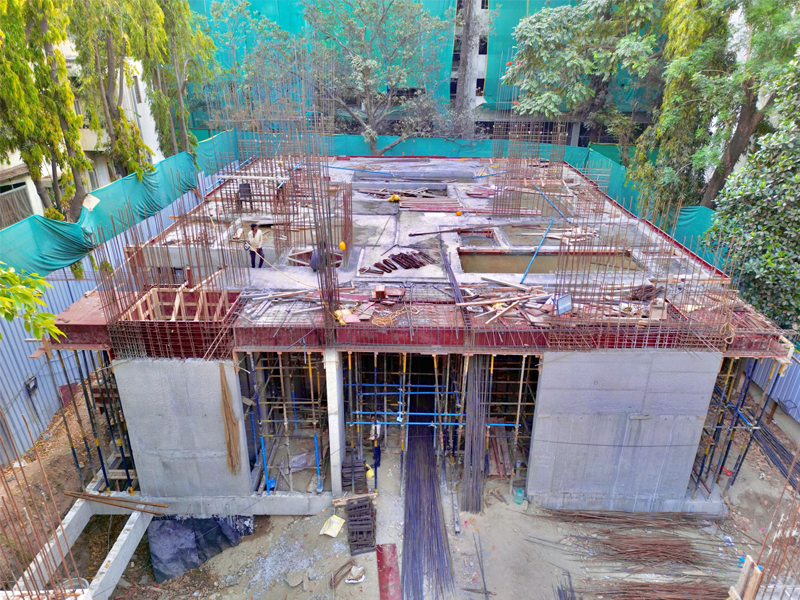

Plinth RCC is finished, 1st slab partially completed, and ongoing work on the remaining slabs.

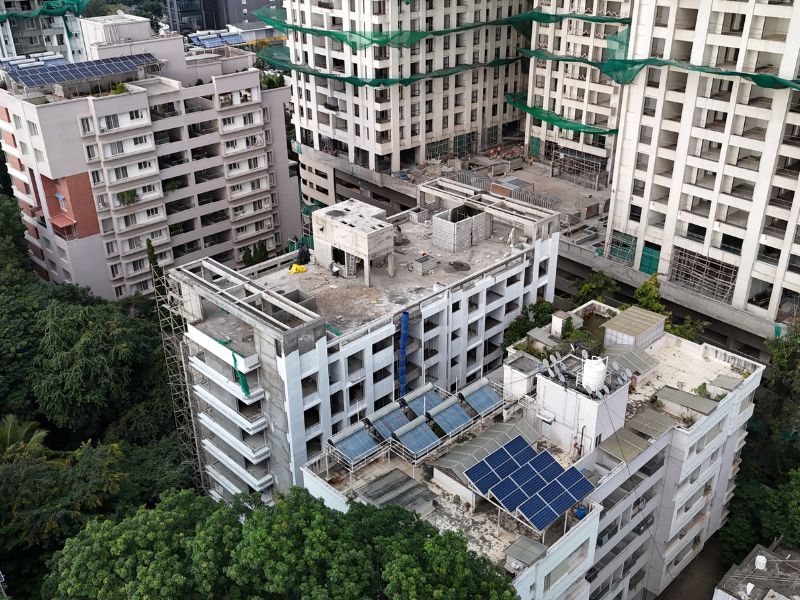

Panchadri

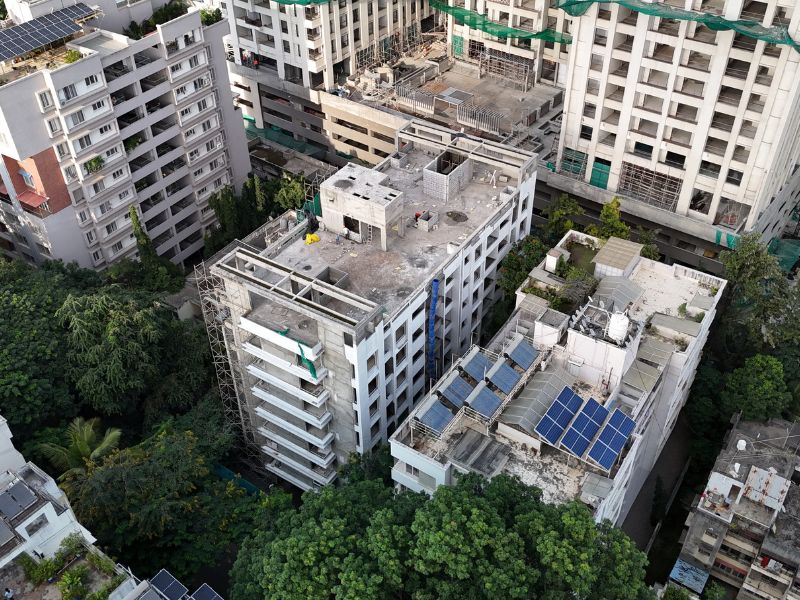

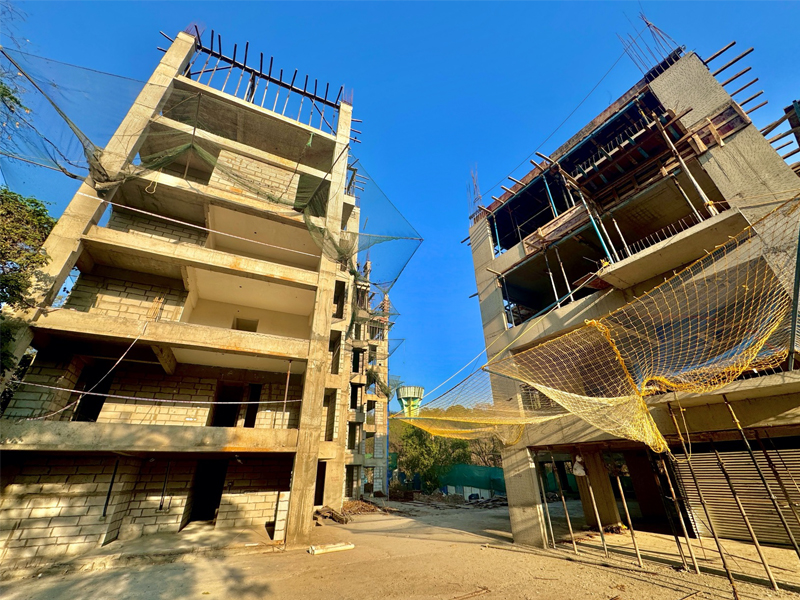

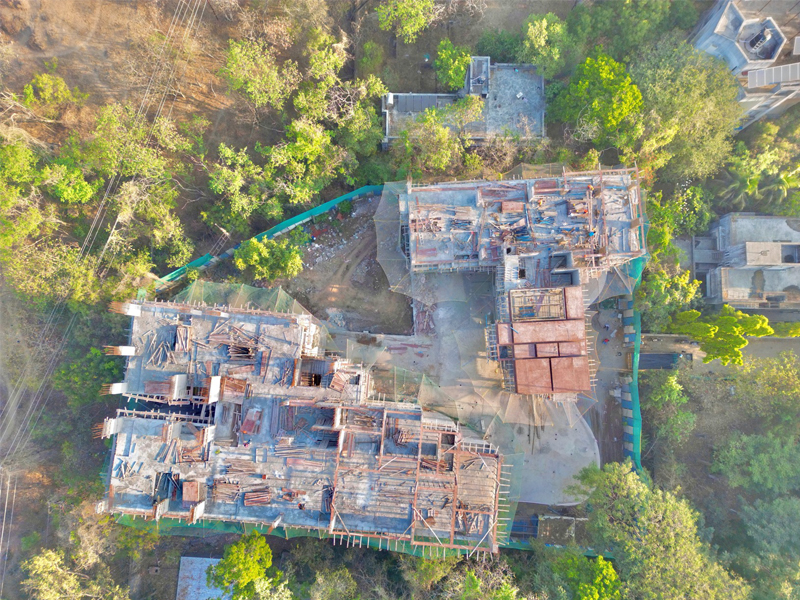

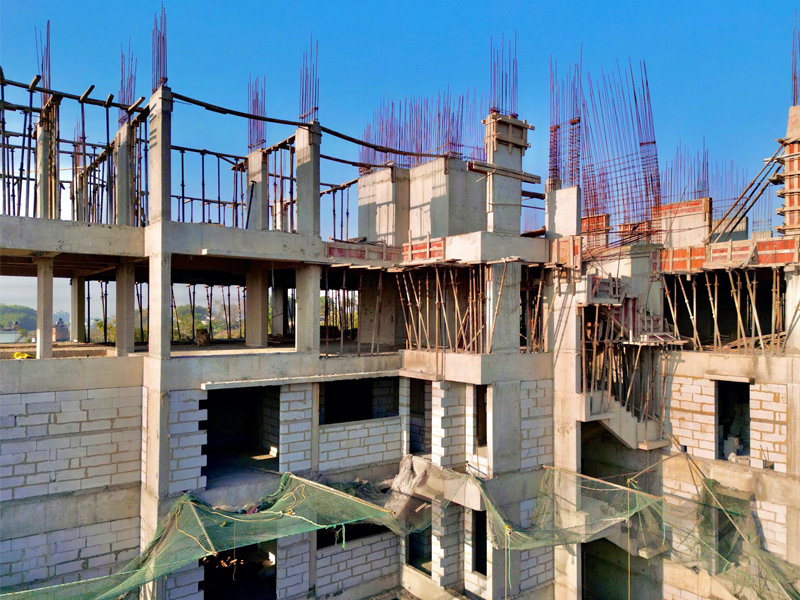

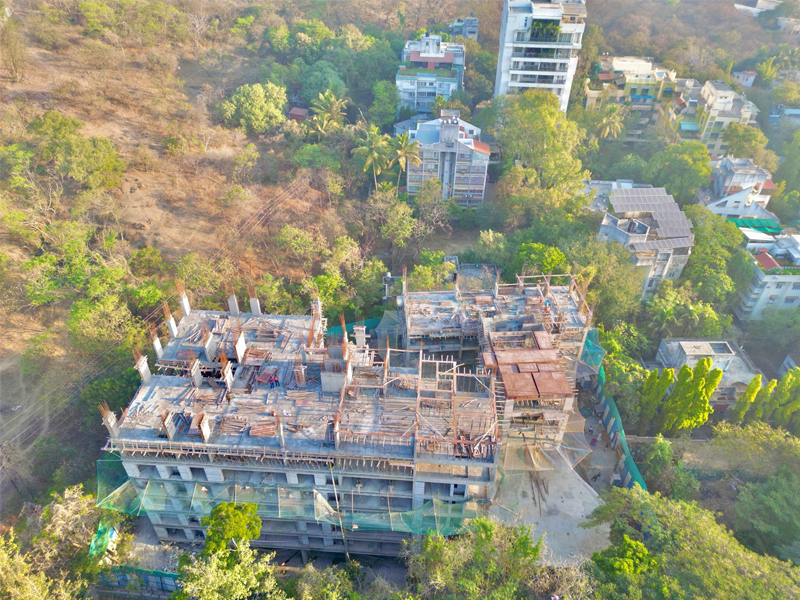

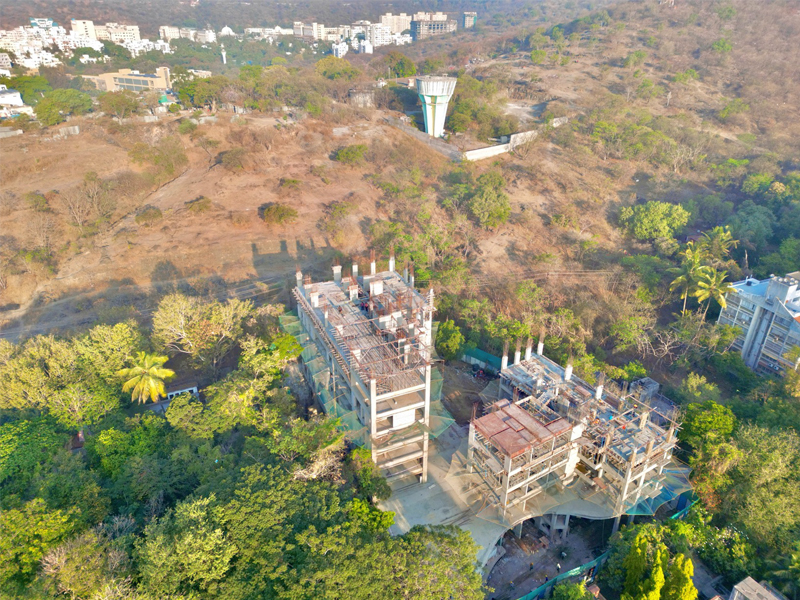

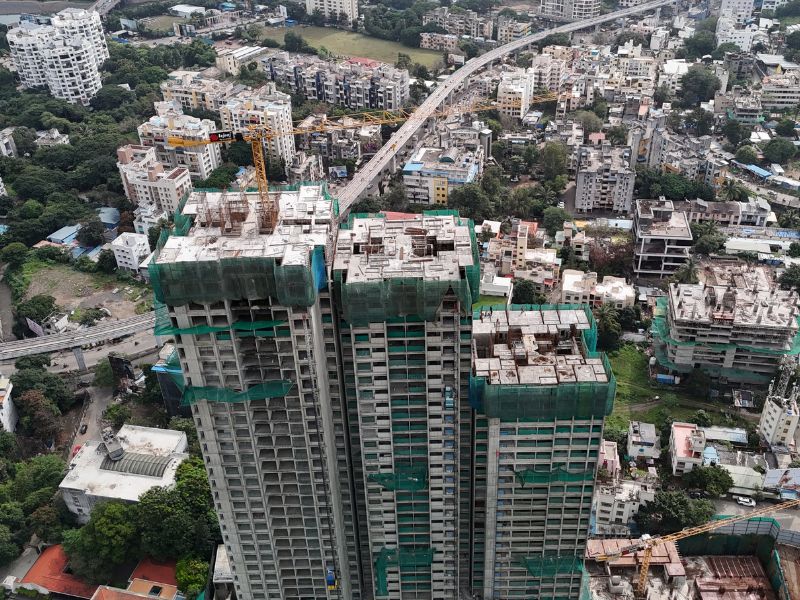

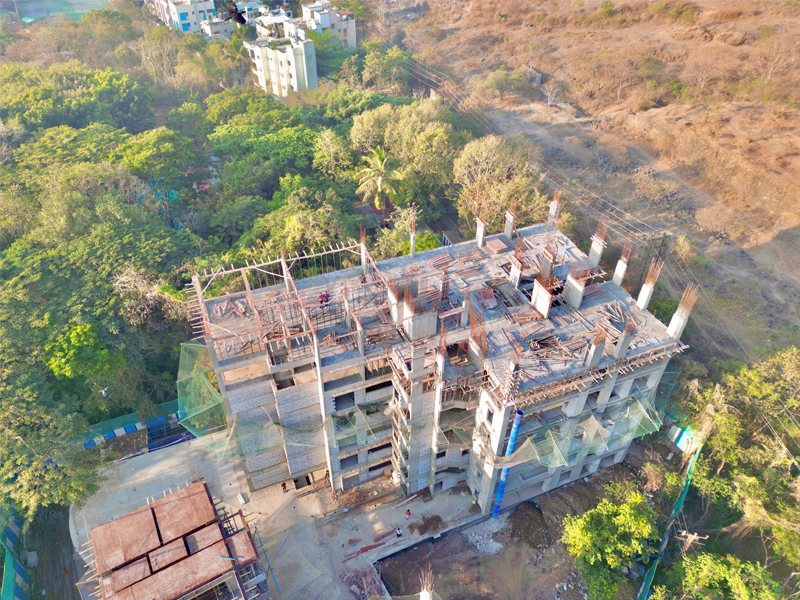

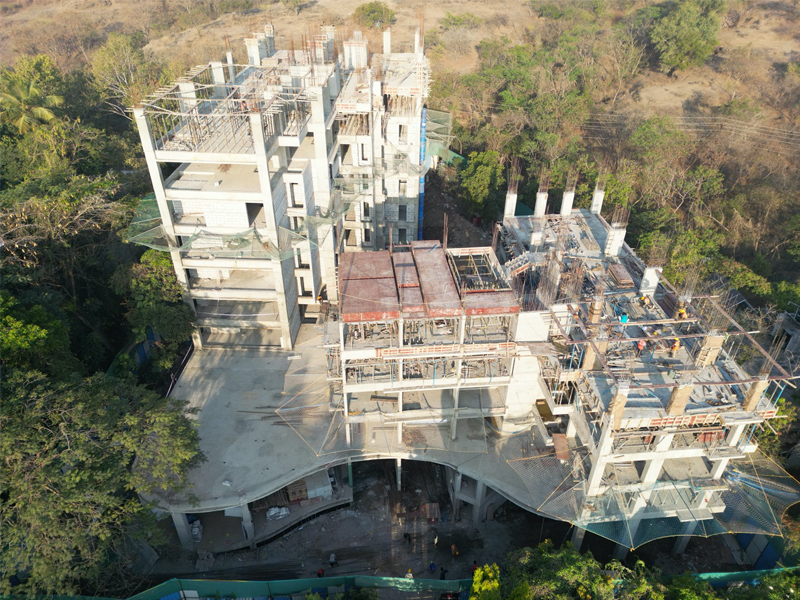

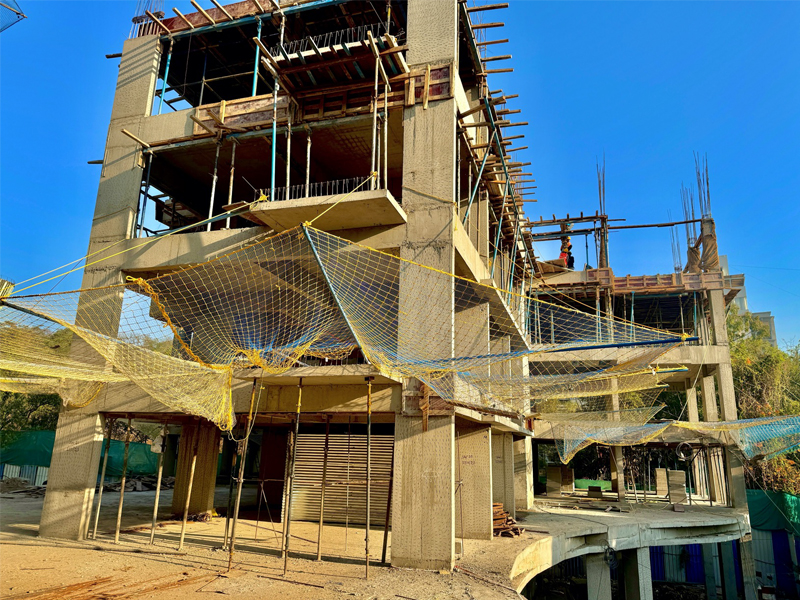

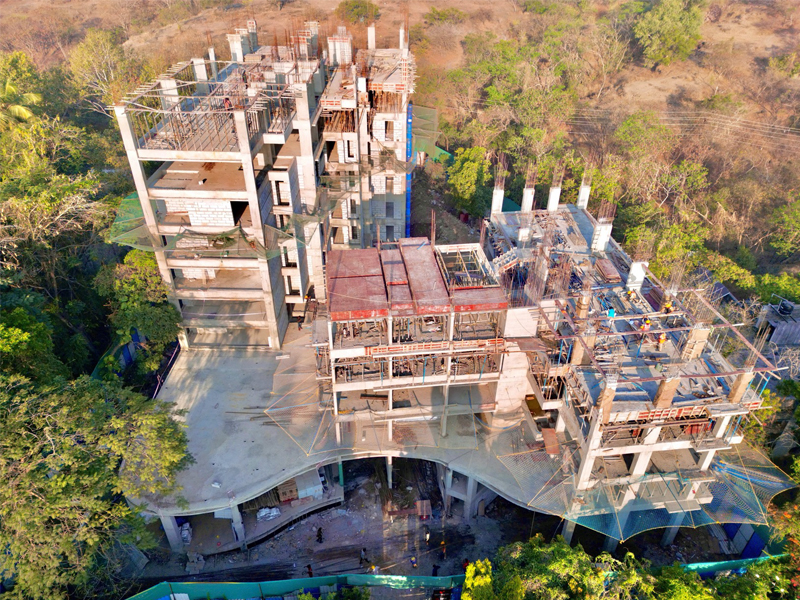

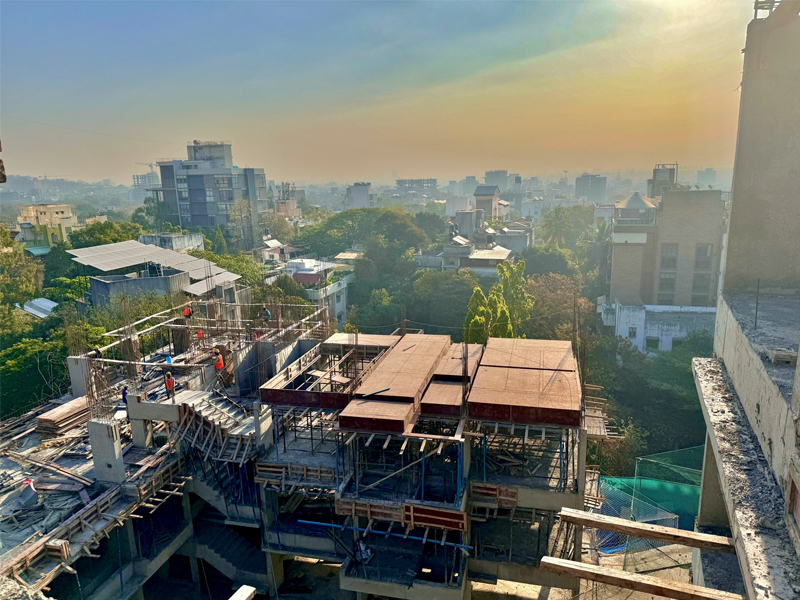

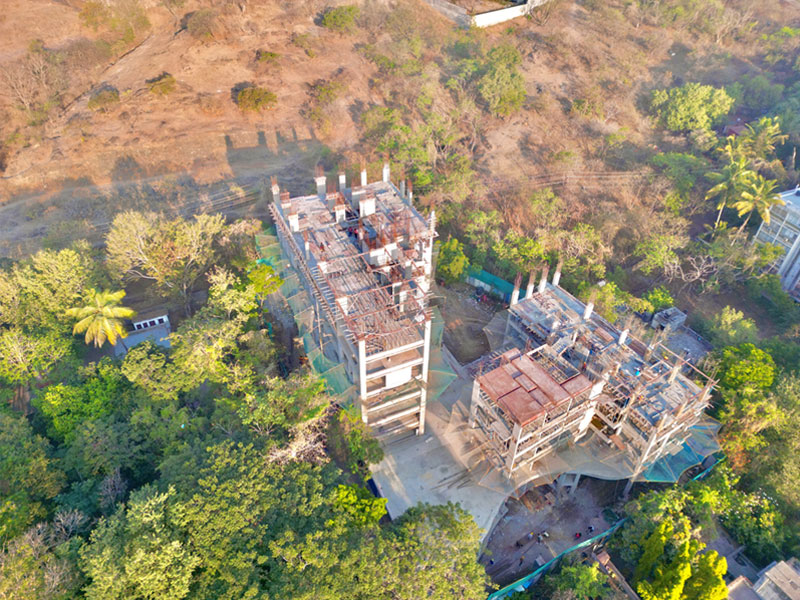

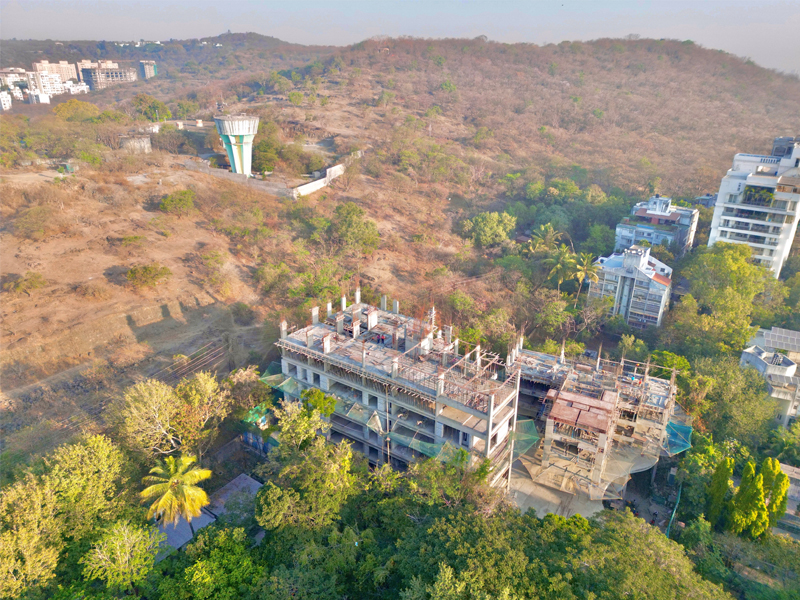

Tower B’s 7th residential floor roof slab and Tower A’s 6th residential floor slab are currently in progress.
